Every successful construction project begins long before the first task is executed. The first step is to understand exactly what materials, quantities, labor, and equipment the project will require. This is where a construction takeoff comes in. If you’re confused about what it means and what it could do for your project, you’ve found the right guide.
Construction takeoff lays the foundation for accurate estimates, precise pricing, and smarter procurement by turning project drawings into measurable quantities. In the following sections, we’ll explain what a construction takeoff is, what it includes, how to create it, the common mistakes to avoid, and how software tools can make the entire process faster and more accurate. Continue reading to find out more!
Key Takeaways
- A construction takeoff identifies and notes all the materials, quantities, labor, and equipment needed before estimating or bidding.
- Quantity takeoffs measure how much is needed, while material takeoffs specify what is required.
- Following a structured takeoff process and reviewing the final document helps minimize costly errors.
- Modern takeoff software and third-party service providers, like Track3D’s Reality Intelligence, speed up measurements, reduce manual work, and improve team collaboration.
- Avoid common mistakes, like using outdated drawings, ignoring specifications, or missing waste allowances.
- Connecting takeoff data with real-time site progress helps teams track planned versus actual work more effectively.
What Is a Construction Takeoff?
A construction takeoff is the process of identifying, measuring, and listing every material and resource a project needs before a single estimate is written or a bid is submitted. It is a preconstruction exercise where an estimator or a dedicated takeoff team analyzes the project drawings, specifications, and plans in order to list every item that will be needed to complete the job.
The word “takeoff” comes from actually taking numbers off the drawings and physically counting, measuring, and recording what’s on plan. Because of this core idea, even though the process is now entirely digital, construction takeoffs are completed at the preconstruction stage itself. The output includes all major information, like bid price, procurement schedules, subcontractor scoping, and project budgets. But for detailed information, check out the sections below.
Not all construction firms have the capacity to conduct thorough research for estimation and create construction takeoff reports. Here, third-party providers can help fill the gap. They review your project drawings and deliver a comprehensive construction takeoff, usually within a defined turnaround window. Teams or stakeholders who’ll find them useful are:
- Subcontractors bidding on short notice
- Specialty trades without dedicated estimating staff
- General contractors managing high bid volumes
- Firms entering new markets where internal expertise is thin
If you end up opting for a construction takeoff service, ensure that you look at their trade specialization, turnaround time, format compatibility with your estimating software, and how they handle revisions. Because, at the end of the day, a service that delivers fast but cannot accommodate RFIs mid-bid creates more problems than it solves.
What Is Included in a Construction Takeoff?
A comprehensive construction takeoff includes the following layers:
- Materials: This includes every physical item that the project will require, from structural steel to door hardware.
- Quantities: This is a detailed measurement of all aspects of the project, like square footage, linear footage, cubic yards, or unit counts.
- Labor: The team would estimate the number of hours required for each trade based on productivity rates.
- Equipment: Cranes, lifts, formwork, and other machinery required for execution are considered and estimated here.
- Unit Costs: To generate the right construction takeoff, we need to incorporate the current price per unit for each material, sourced from supplier quotes or pricing databases.
Ultimately, the finished construction takeoff is an item-by-item breakdown that makes the estimation process structured and auditable.
Understanding Quantity Takeoff vs. Material Takeoff
Before we consider a detailed example of how a construction takeoff looks, let’s first understand the difference between quantity takeoff and material takeoff. A lot of teams tend to use these terms interchangeably, but they refer to distinct outputs. A quantity takeoff answers “how much,” whereas a material takeoff answers “what exactly.” For instance, consider this table for a better summary:
| Particulars | Quantity Takeoff | Material Takeoff |
|---|---|---|
| Focus | How much of something is needed | What specific materials are needed |
| Output | Numbers, counts, measurements | A bill of materials with descriptions |
| Used for | Estimating and bidding | Procurement and purchasing |
| Example | 2,400 sq. ft. of drywall | Type X fire-rated gypsum board, ⅝” |
In other words, a quantity takeoff produces counts and measurements, like linear feet of pipe, square footage of flooring, and cubic yards of concrete, and a material takeoff answers the specific type of material, grade, size, and description. Both are equally crucial and typically developed together.
Example of a Construction Takeoff
In the following table, we explore a simplified construction takeoff example for a concrete slab. Note that this is a simplified version, and construction takeoff for large-scale projects can be much more complex. Each row in this construction takeoff table connects a specific drawing element to a measurable quantity and a cost. Multiply this across all trades and all scopes on a large commercial project, and we understand why accuracy at this stage is so critical.
| Description | Quantity | Unit | Unit Price | Total |
|---|---|---|---|---|
| 4″ concrete slab, ground floor | 3,200 | Sq. ft. | $8.50 | $27,200 |
| Rebar, a #4 deformed bar | 1,800 | Linear ft. | $1.20 | $2,160 |
| Wire mesh reinforcement | 3,200 | Sq. ft. | $0.65 | $2,080 |
| Formwork, perimeter edge | 240 | Linear ft. | $4.000 | $960 |
According to the Construction Financial Management Association (CFMA), direct costs typically account for 85 to 92% of total project costs. Thus, an error in the takeoff does not stay small; it compounds.
How to Do a Construction Takeoff: Step-by-Step Guide

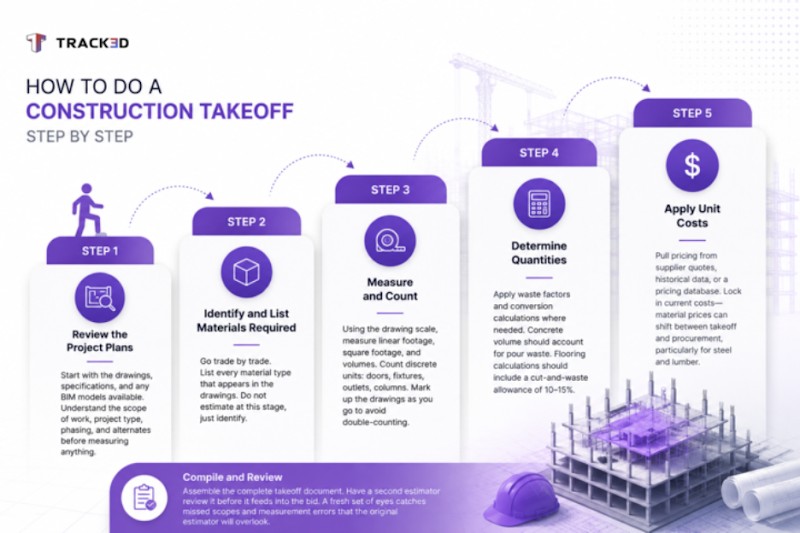

In this section, we explore how to conduct a construction takeoff in detail. Follow the steps to procure an in-depth, comprehensive document.
Step 1: Review the Project Plans
Begin your review with drawings, specifications, and any BIM models available. Read and understand the scope of work very carefully. Also understand the project type, phasing, and any alternates before you start measuring any parameter.
Step 2: Identify and List the Materials Required
Analyze the entire project trade-by-trade. List every material that appears in the drawings. Identifying all the required materials at this stage is extremely important, since this is your baseline setup to create a useful construction takeoff.
Step 3: Measure and Count
This is the major, crucial stage of creating a comprehensive construction takeoff. Use the drawing scale to measure linear footage, square footage, and volumes. Also count discrete units, like doors, fixtures, outlets, and columns. You can simultaneously mark up the drawings as you go to avoid double-counting.
Step 4: Determine the Quantities
In this step, you must begin forming estimates of the quantities. Apply waste factors and conversion calculations wherever needed. For instance, concrete volume should account for pour waste. Flooring calculations should include a cut-and-waste allowance of 10 to 15%, but, of course, verify the actual figures with your supplier.
Step 5: Apply Unit Costs
This is where you start making estimates of the cost. You should pull pricing from supplier quotes, historical data, or a pricing database. Lock in current costs since material prices can shift between takeoff and procurement, particularly for steel and lumber.
Step 6: Compiled Review
Assemble the complete takeoff document. You can even have a second estimator review it if needed to ensure that it’s error-free before it feeds into the bid. A fresh set of eyes in review often catches missed scopes and measurement errors that might be missed otherwise.
Choosing Construction Takeoff and Estimating Software
Over the years, the market for construction takeoff and estimating software has grown significantly, and there are many platforms that offer these services. And most of them take the estimators away from manual spreadsheets toward digital workflows that are faster and much less prone to error. But before choosing, here are the parameters that you should consider and keep in mind:
- Digital measurement tools: Can the software measure directly from uploaded PDFs or CAD files? The core idea is that it should be able to calibrate once and measure everything from there.
- 2D and 3D support: This refers to the ability to pull quantities from BIM models as well as 2D drawings, so estimators have flexibility across project types.
- Automated counting: Some platforms use artificial intelligence to detect and count repeating symbols, like outlets, fixtures, and columns, across drawing sets.
- Cost databases: If the software has built-in or integrated pricing data, it will help reduce the time an estimator would otherwise spend on collecting supplier quotes for early-stage estimates.
- Cloud collaboration: If multiple estimators are working on the same file simultaneously, it’s always a plus to have version control, especially on complex projects.
- Integration with project management tools: Takeoff data that automatically flows into your project management or scheduling platform will eliminate manual re-entry and reduce reconciliation errors.
Integration with project management tools is far more important than most teams realize. A comprehensive, detailed construction takeoff that is connected with what’s happening on site means the gap between what was estimated and what is being done in real time becomes instantly apparent.
This is where Track3D comes into the picture. Because once construction is underway, the quantities from the takeoff become the baseline against which actual field progress is measured. Track3D’s Reality Intelligence, the automated analysis of site imagery against planned data, turns those takeoff numbers into live progress benchmarks, so project teams do not have to chase information they should already have.
Common Takeoff Mistakes and How to Avoid Them
In this section, we briefly discuss the common mistakes that occur while generating construction takeoff data, in addition to how to avoid them.
| Common Mistakes | How to avoid them |
|---|---|
| Skipping the specification review | Drawings only tell you the geometry, but you need specifications to tell you about the grade type and performance requirements. Do not miss those; otherwise you’ll end up pricing the wrong material. |
| Not accounting for waste | Raw materials will rarely imply direct order quantities. Thus, you must apply appropriate waste factors before finalizing quantities. |
| Using outdated pricing | Prices of materials are subject to change. It’s important to create a takeoff built on current and relevant prices, not last year’s outdated ones. |
| Working from superseded drawings | Ensure that you are taking off from the latest revision. Issued-for-construction documents are always the source of truth. |
| Not conducting an independent check | Keep time and space for a review! A self-review catches about half of the errors. A second estimator reviewing the same scope catches the rest. |
Is a Construction Takeoff Always Enough?
A construction takeoff is a detailed review and is built on what the drawings and plans say will be built. But once construction begins, the project shifts from plans to what is actually being built. And more often than one would expect, these pictures do not match.
For instance, scope changes, sequencing adjustments, weather delays, and subcontractor performance all create gaps between the plan and the field. A takeoff won’t update itself automatically. What teams need is a reliable way to compare planned quantities against actual field installation; otherwise, project teams will be forced to revert to manual verification, like site walks, spreadsheets, and weekly reports that are also outdated for new-age digital construction workflows.
The most forward-thinking teams are closing this loop by connecting preconstruction data to field intelligence. That connection between what was taken off and what was installed is where the next generation of project controls is being built.
Conclusion

A construction takeoff is a great way to generate accurate estimates about the project you’re working on and have all the details in one place. It is the perfect way to determine the materials, costs, and labor you will need. You can also outsource this job to other third-party service providers who can look at your plans and create a construction takeoff for you. And most importantly, it should be integrated into your current workflows so you can keep track of what’s planned and what’s being built, helping your team spend less time chasing updates and more time making decisions.
Frequently Asked Questions About Construction Takeoff
Q1. What is a construction takeoff?
Ans: A construction takeoff is the process of reading project drawings and listing every material, quantity, and unit of labor or equipment needed to complete the job.
Q2. What is the difference between a quantity takeoff and a material takeoff?
Ans: A quantity takeoff measures how much of something is needed, like square footage, linear feet, and cubic yards. A material takeoff, on the other hand, specifies the type, grade, and specification. Both are usually developed together.
Q3. How long does a construction takeoff take?
Ans: It depends on the project complexity and scope. A single-trade takeoff on a straightforward project can take a few hours. A full multi-trade takeoff on a large commercial project may take several days or longer.
Q4. What is construction takeoff software used for?
Ans: Construction takeoff and estimating software digitizes the measurement and counting process, reducing manual error and speeding up quantity extraction from 2D drawings or BIM models. It also helps teams collaborate and track drawing revisions.
Q5. What are construction takeoff services?
Ans: Construction takeoff services are third-party providers that review your project drawings and deliver a complete quantity and material takeoff on your behalf. They are useful for firms with limited in-house estimating capacity or high bid volumes.
Q6. Is a construction takeoff the same as an estimate?
Ans: No. A takeoff produces the quantity of data. An estimate applies pricing to that data to arrive at a project cost. The takeoff feeds the estimate, but it is not the estimate itself.
